Streetcar Progress Update: April 18, 2014
Apr 18, 2014
Streetcar Progress Update: Week Ending April 18, 2014
This week marks a big milestone for the Streetcar Project. Work began on the first curved section of track at Henry & Elm streets.

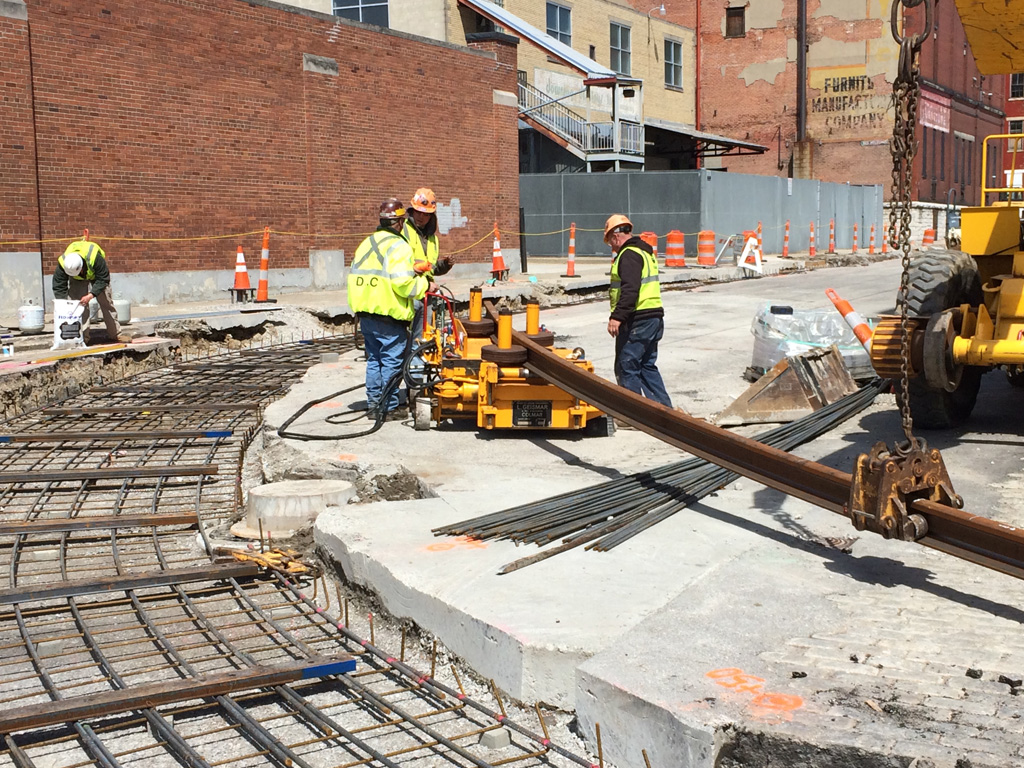

In the photo, you can see how crews suspend sections of rail as a series of rollers bend it to the proper radius.
.jpg)

Construction crews started erecting structural steel at the Maintenance & Operations Facility this week. This steel provides the framework for the building. Work will continue for about 6 weeks.

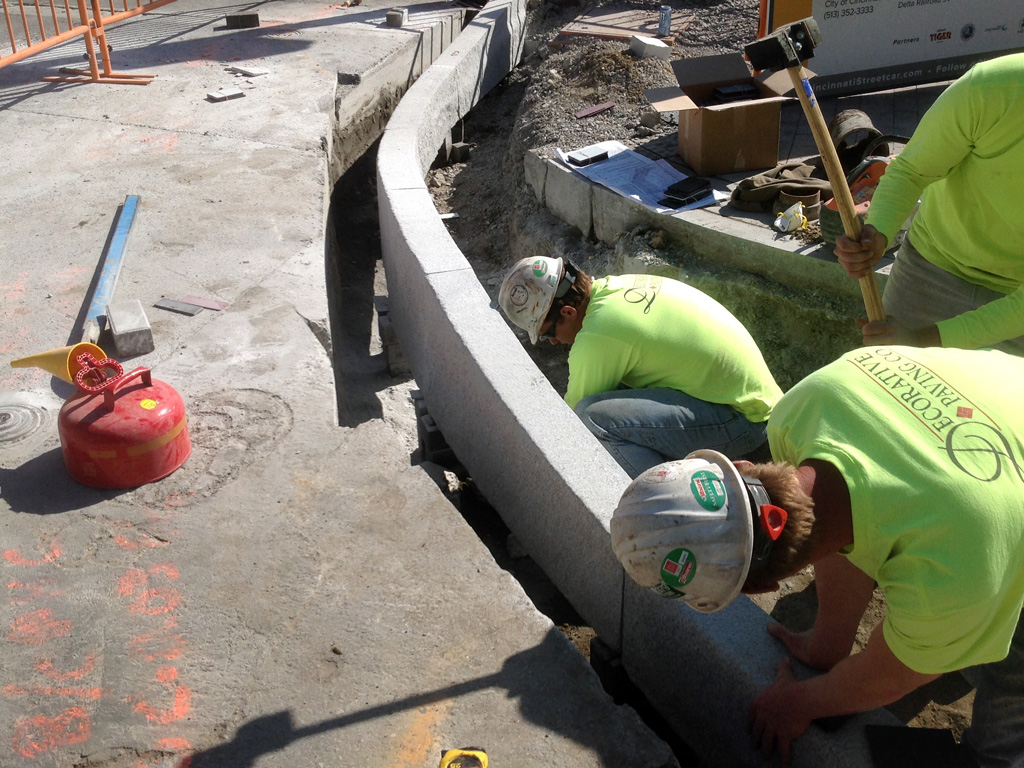

Work on the station stop outside of Music Hall continues with the setting and leveling of granite curb. Design features such as granite curb and tiles were chosen to match Washington Park's renovation.

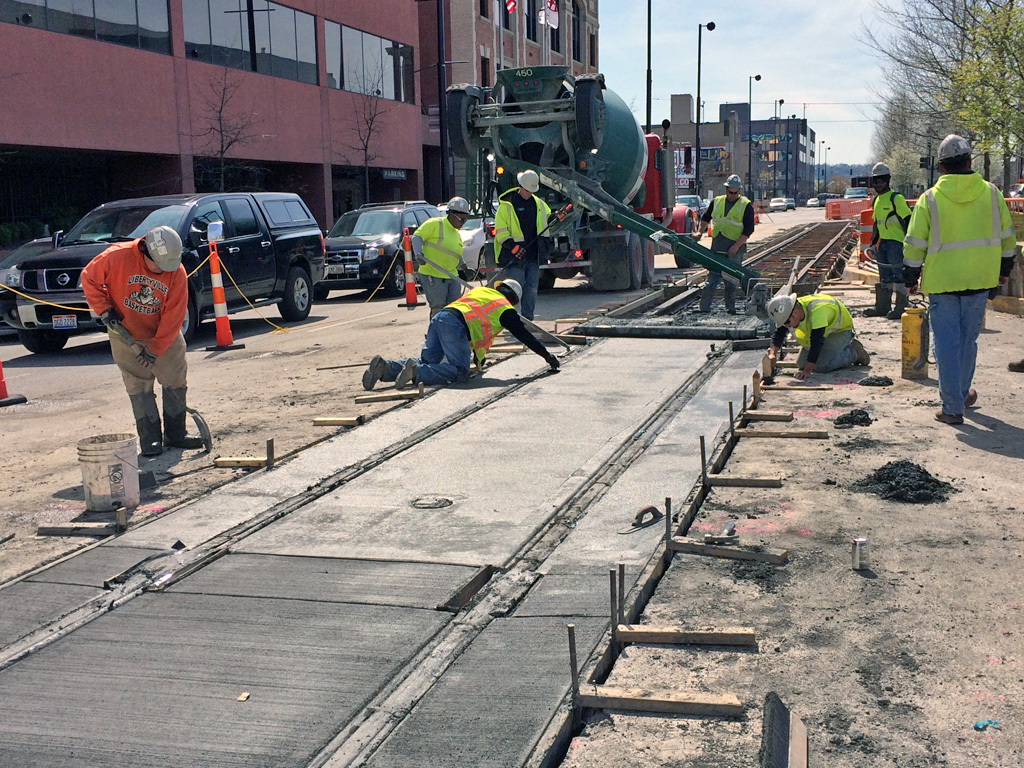

Trackwork continues on Central Parkway, completing 6,621 track feet to date.
Traffic Alerts
The westbound lanes of Central Parkway at Race Street will be closed from 6 p.m. Thursday, April 24, until 7 a.m. Monday, April 28, so crews can do prep work for track installation.
Progress This Week
Main Street
- 6th to 8th: Underground electrical work
- Court to 12th: Underground gas work
- At 12th: Underground electrical work
12th Street
- Main to Vine: Underground gas work
- Vine to Baldwin Alley: Underground electrical work
- At Race: New sewer installation
- Race to Elm: Pole foundations and conduit for overhead power and traffic signals
Elm Street
- At 14th: Concrete work on Stop #8
- 14th to Findlay: Overhead electrical work
- At Liberty: Concrete work on Stop #8
- Wade to Glass Alley: Telecomm work
- At Henry: Track concrete base work; rail installation
Race Street
- 13th to 14th: Pole foundations and conduit for overhead power and traffic signals
- Liberty to Green: Pole foundations and conduit for overhead power and traffic signals
- Green to Sellew Alley: Telecomm work
- Liberty to Henry: Overhead electrical work
- At Henry (Maintenance & Operations Facility): Masonry; structural steel
Central Parkway
- Race to Vine: Track concrete base work; rail installation; street restoration
- Vine to Walnut: Trenching; track concrete base work
Walnut Street
- 5th to 6th: Chilled water work
- Government Place to 7th: Water main installation
Planned For Next Week
Main Street
- 2nd to 6th: Sewer work (1 week remaining at this location)
- 6th to 7th: Underground electrical work (3 weeks remaining at this location)
- 7th to 8th: Underground electrical work (1 week remaining at this location)
- 9th to Court: Underground electrical work (4 weeks remaining at this location)
- Court to 12th: Underground gas work (1 week remaining at this location)
- At 12th: Underground electrical work (2 weeks remaining at this location)
12th Street
- Main to Vine: Underground gas work (1 week remaining at this location)
- Vine to Baldwin Alley: New sewer installation (1 week remaining at this location); underground gas work (2 weeks remaining at this location); sewer work (1 week remaining at this location)
- At Race: New sewer installation (1 week remaining at this location)
- Race to Elm: Pole foundations and conduit installation for traffic signals and overhead power (1 week remaining at this location)
Elm Street
- At 14th: Concrete work on Stop #7 (2 weeks remaining at this location)
- 14th to Findlay: Overhead electrical work (4 weeks remaining at this location)
- Wade to Glass Alley: Telecomm work (1 week remaining at this location)
- At Henry: Track concrete base work (1 week remaining at this location); rail installation (1 week remaining at this location)
Race Street
- At Central Parkway: Trenching (1 week remaining at this location); track concrete base work (1 week remaining at this location); rail installation (1 week remaining at this location)
- 12th to 14th: Sewer work (1 week remaining at this location)
- 13th to 14th: Pole foundations and conduit installation for overhead power and traffic signals (1 week remaining at this location)
- Green to Sellew Alley: Telecomm work (1 week remaining at this location)
- Liberty to Henry: Overhead electrical work (4 weeks remaining at this location)
- At Henry (Maintenance & Operations Facility): Masonry (11 weeks remaining at this location); structural steel (7 weeks remaining at this location)
Central Parkway
- Race to Vine: Track concrete base work (1 week remaining at this location); sewer work (1 week remaining at this location)
- Vine to Walnut: Rail installation (2 weeks remaining at this location); sewer work (1 week remaining at this location); track concrete base work (2 weeks remaining at this location)
Walnut Street
- 2nd to 3rd: Sewer work (1 week remaining at this location)
- 5th to 6th: Chilled water work (1 week remaining at this location); telecomm work (2 weeks remaining at this location)
- Government Place to 6th: Sewer work (1 week remaining at this location)
- Government Place to 7th: Water main installation (1 week remaining at this location)
- At Central Parkway: Pole foundations and conduit installation for traffic signals and overhead power (2 weeks remaining at this location); sewer work (1 week remaining at this location)
