Streetcar Progress Update: May 11, 2015

May 08, 2015

Streetcar Progress Update: May 11, 2015

9th & Main Intersection to Close This Weekend for Track Work

This weekend, construction crews will be installing trackwork through the intersection of 9th and Main Streets.  9th Street will be closed at Main starting Friday, May 15 at 7:00pm until Monday, May 18 at 6:00am.

Please consult RoadMapCincy.com for details on detours and alternate routes.

Block by Block Construction –May 11-17, 2015

MAIN STREET:

  • At 2nd:    TPSS #1 concrete work, traffic control conduit work, Stop #1 power work (1 week remaining)
  • 3rd to 6th: potholing and pavement restoration (2 weeks remaining)
  • 4th to 6th: traffic control conduit work (1 week remaining)
  • 6th to 7th: storm sewer work (1 week remaining)
  • 7th to 8th:  OCS foundations (2 weeks remaining)
  • 8th to 9thtrack concrete base work, rail installation ( 2 weeks remaining);  pavement removal (1 week remaining)
  • 9th to Court:  track concrete base work, rail installation (1 week remaining)
  • Court to 12th:  Stop #5A concrete work (2 weeks remaining), OCS foundations (1 week remaining)
  • At 12th:  OCS foundations (1 week remaining)

 WALNUT STREET:

  • 2nd to 3rdOCS pole setting, rail installation (1 week remaining)
  • 3rd to 4th:  OCS pole setting ( 1 week remaining),  track concrete base work (2 weeks remaining)
  • 4th to 6th:  OCS pole setting (2 weeks remaining)
  • 6th to 7th sidewalk pavers to be restored (1 week remaining)

RACE STREET:

  • Henry to Glass Alley:  signal/snowmelter cabinet installation (3 weeks remaining);  asphalt milling & grinding (1 week remaining), asphalt surface course (2 weeks remaining)
  • At 12thSignal/snowmelter cabinet installation (3 weeks remaining)
  • At Central Parkway: asphalt milling & grinding (1 week remaining), asphalt surface course (2 weeks remaining)

12th STREET:

  • Elm to Main:  traffic signage installation (1 week remaining), asphalt surface course (1 week remaining)

  • At Race:  OCS span wire installation (1 week remaining)

  • At Elm:  OCS span wire installation (1 week remaining)

CENTRAL PARKWAY:

  • Race to Walnut:  : asphalt milling & grinding, asphalt surface course (1 week remaining)
  • Race to Vine: traffic signal work (2 weeks remaining)

PROGRESS LAST WEEK:

pole install

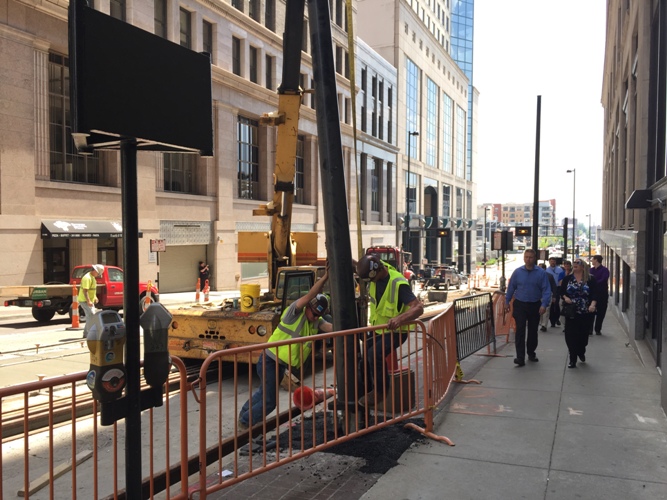

Crews install OCS poles on Walnut Street near 4th

12th & vine paving

12th Street at Vine is repaved to a nice, smooth finish.

3rd & walnut track

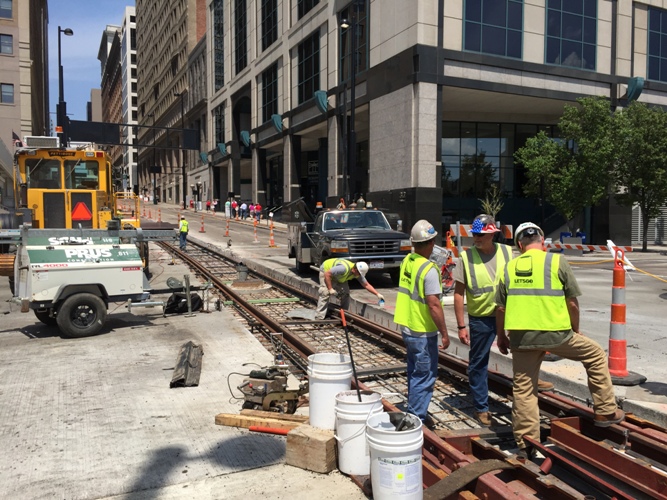

Crews lay track through the intersection of 3rd and Walnut.

elmira

There are still several components to install and a lot of testing to perform, but things are moving along in Elmira as the vehicle production continues.
