Streetcar Progress Update: April 20, 2015
Apr 19, 2015
Streetcar Progress Update: April 20, 2015
Central Parkway at Main Closure this Weekend as Trackwork Moves South on Main Street
Central Parkway will be closed at Main Street this weekend starting at 9:00AM on Friday April 24 until 7:00am on Monday, April 27 to enable trackwork across Central Parkway on Main. Detours will be posted.
Crews to Pull Race Street Overhead Wire this Week
The second major stretch of overhead contact system (OCS) wire to be installed on the Cincinnati Streetcar system is scheduled to be pulled this week on Wednesday April 22 along Race Street between Henry and 12th Streets. Crews will be working overnight along Race to install the overhead wire from which the streetcar will draw electric power.
Monthly Streetcar Updates Available Online
The latest report to City Council’s Major Transportation & Regional Cooperation Committee is available for download at the Cincinnati Streetcar website. You can also access the latest Streetcar Construction Stakeholders Update and Monthly Reports.
Block by Block Construction – April 20-26, 2015
MAIN STREET:
- At 2nd: TPSS #1 concrete work (4 weeks remaining); Stop #1 power work (1 week remaining)
- 4th to 6th: potholing and pavement restoration (2 weeks remaining)
- 5th to 7th: storm sewer work (2 weeks remaining)
- 7th to 8th: traffic control conduit work (1 week remaining)
- 9th to Court: pavement removal (1 week remaining)
- 8th to 9th: potholing and pavement restoration (1 week remaining)
- Court to 12th: track concrete base work (2 weeks remaining); pavement removal, OCS foundations, traffic control conduit work, rail installation (1 week remaining)
- At 12th: pavement removal (1 week remaining)
WALNUT STREET:
- 3rd to 4th: track concrete base work, rail installation (3 weeks remaining); pavement removal, restorations at water line work (2 weeks remaining); sidewalk and ramp replacement (1 week remaining)
- 4th to 5th: restorations at water line work, track concrete base work (2 weeks remaining), rail installation (1 week remaining)
- 5th to Govt. Place: restorations at water line work (2 weeks remaining); bus pad removal & replacement (1 week remaining)
- Govt. Place to 7th: restorations at water line work (2 weeks remaining)
- 6th to 7th: sidewalk and ramp replacement (1 week remaining)
RACE STREET:
- Henry to Central Parkway: OCS span wire installation (2 weeks remaining)
- Liberty to Green: OCS bracket installation (1 week remaining)
- 12th to 15th: OCS bracket installation, asphalt surface course (1 week remaining)
ELM STREET:
- 12th to 15th: OCS bracket installation (1 week remaining)
12th STREET:
- Elm to Baldwin Alley: Asphalt milling & grinding (2 weeks remaining)
- At Race: OCS bracket installation (1 week remaining)
PROGRESS LAST WEEK:

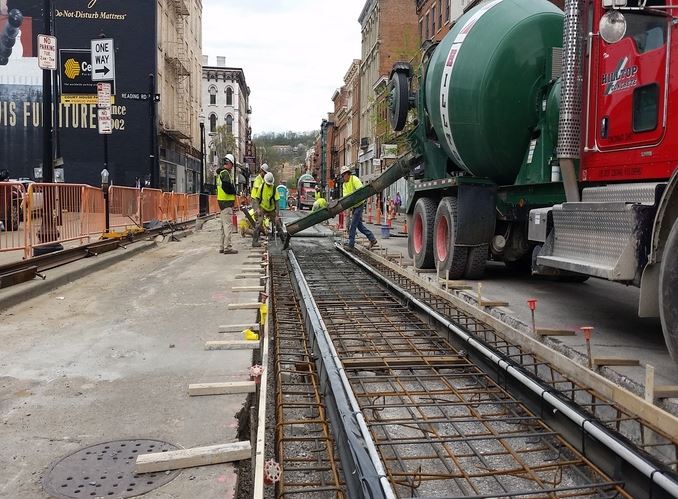

Crews pour concrete for new track on Main at 12th Street

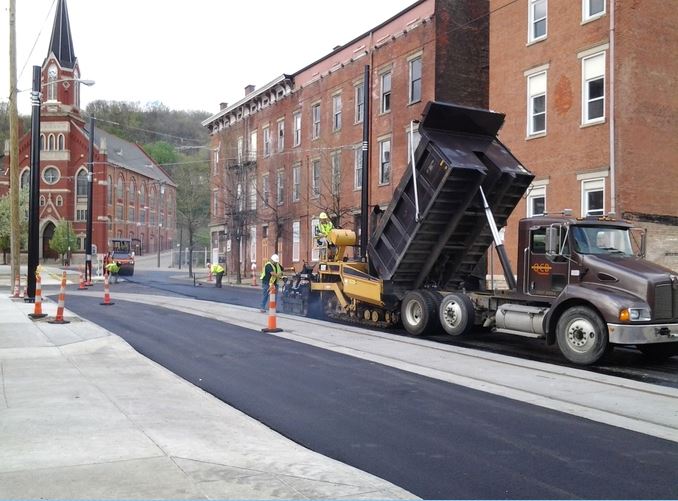

Final paving crews begin working south down Race Street near the MOF site

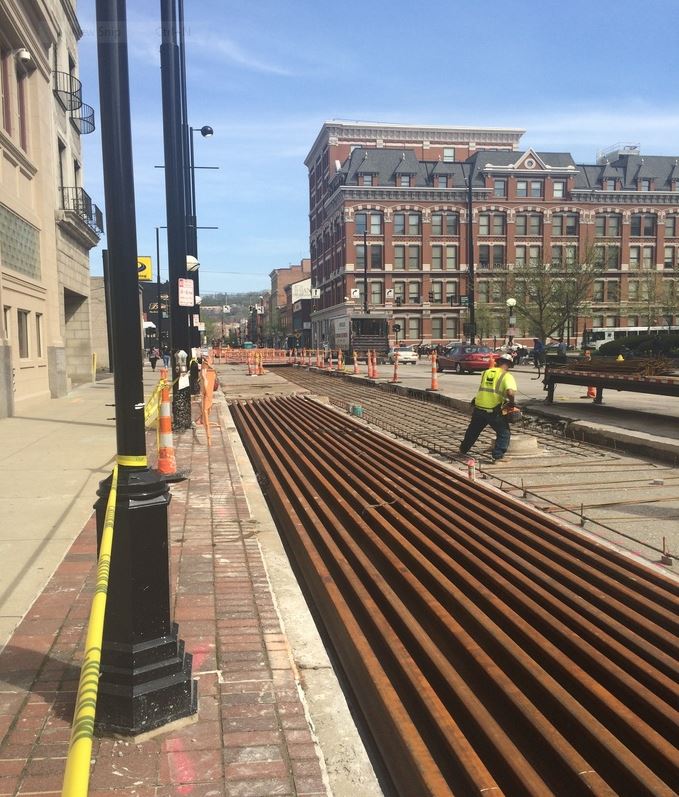

A rail delivery on Main in preparation for trackwork crossing Central Parkway this weekend.
